TOTAL 14 UPDATES
AUGUST, 2026
LATEST UPDATE
📅AUGUST 20, 2025

AUGUST, 2026

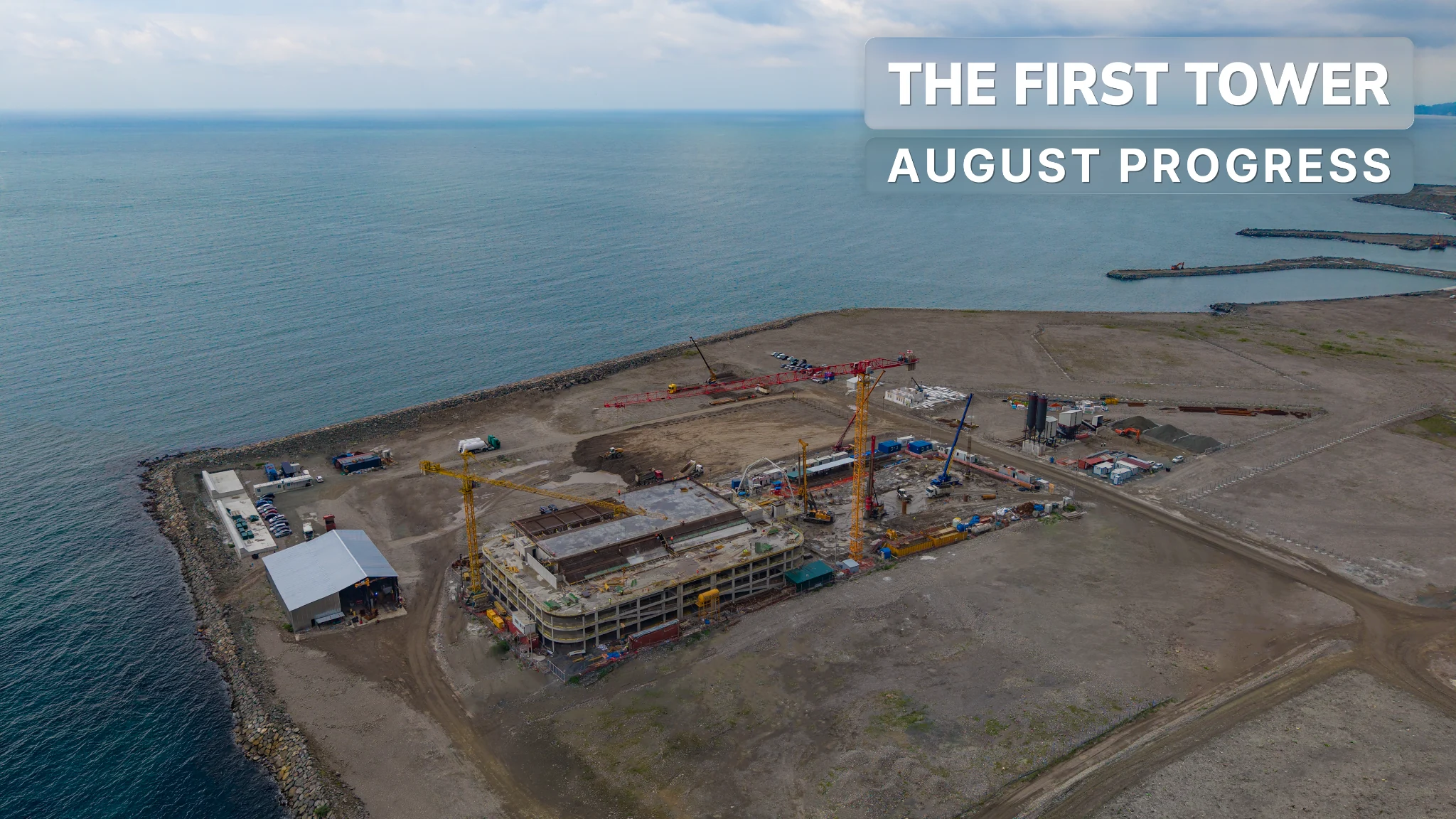

August marked significant construction progress for The First Tower by Ambassadori Island Batumi. In Zone A, the three-level parking structure has taken shape, with concrete slabs completed across all three levels, covering a total area of approximately 9,000 m². Meanwhile, foundation works continue to advance in Zone B. From June through August, 127 foundation piles were installed, completing nearly 64% of the total planned scope. The progress achieved in August brings The First Tower closer to the start of its above-ground construction phase.

🖼️4 Photos

June-July 2026
🖼️4 photos
June-July 2026

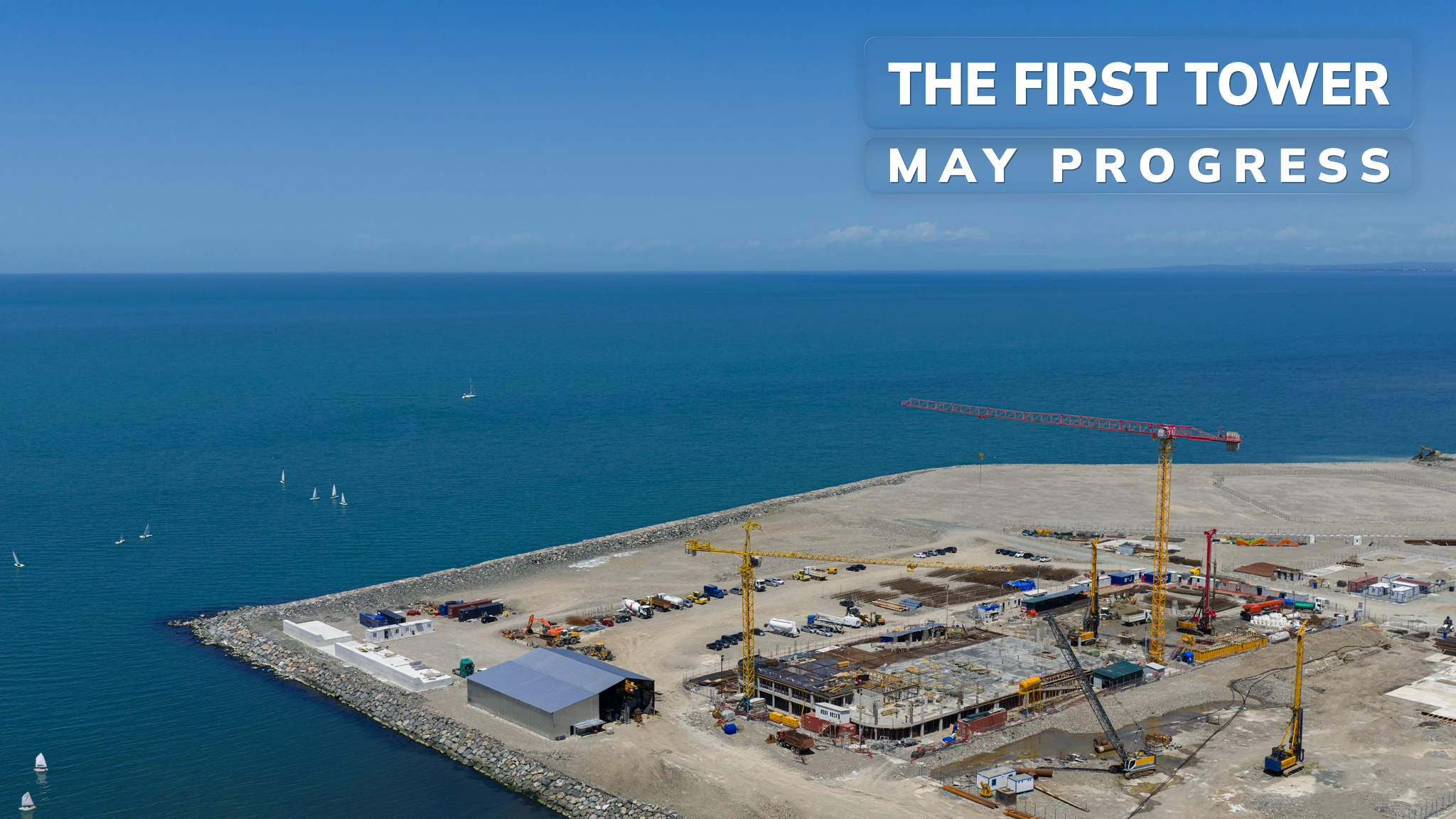

MAY, 2026
🖼️3 photos
20 MAY 2026

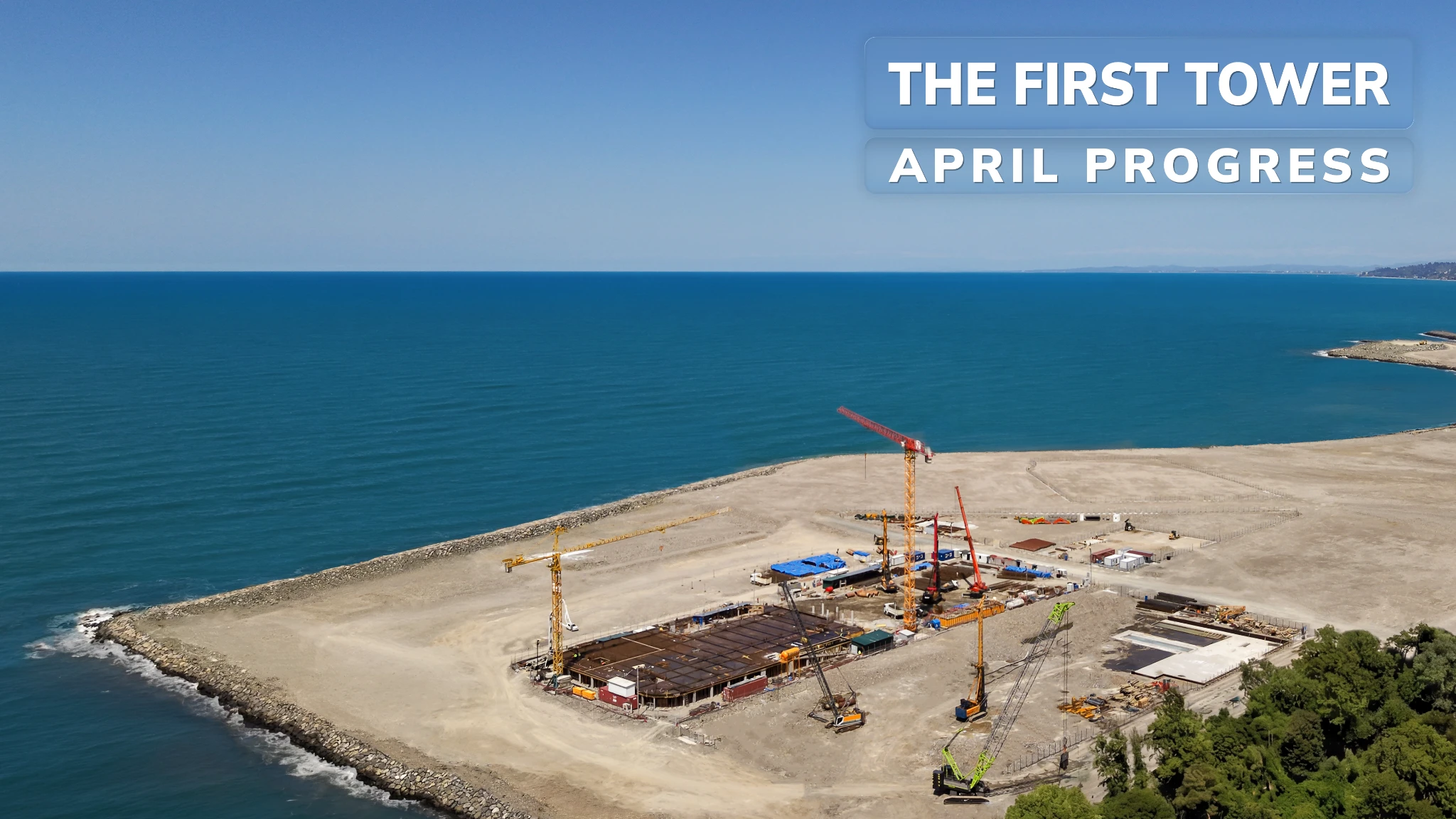

APRIL, 2026
🖼️2 photos
20 APRIL 2026

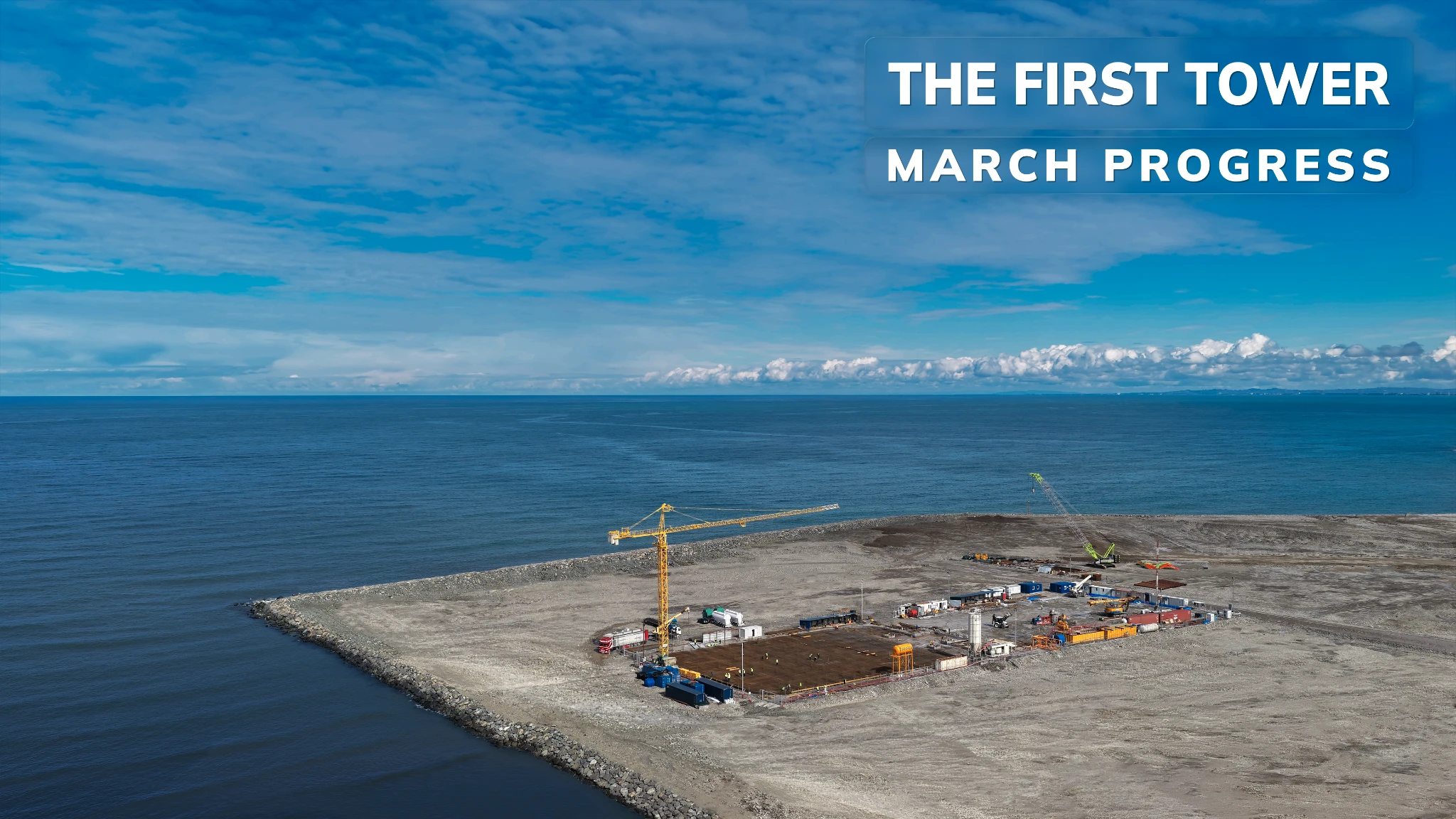

MARCH, 2026
🖼️3 photos
20 MARCH 2025

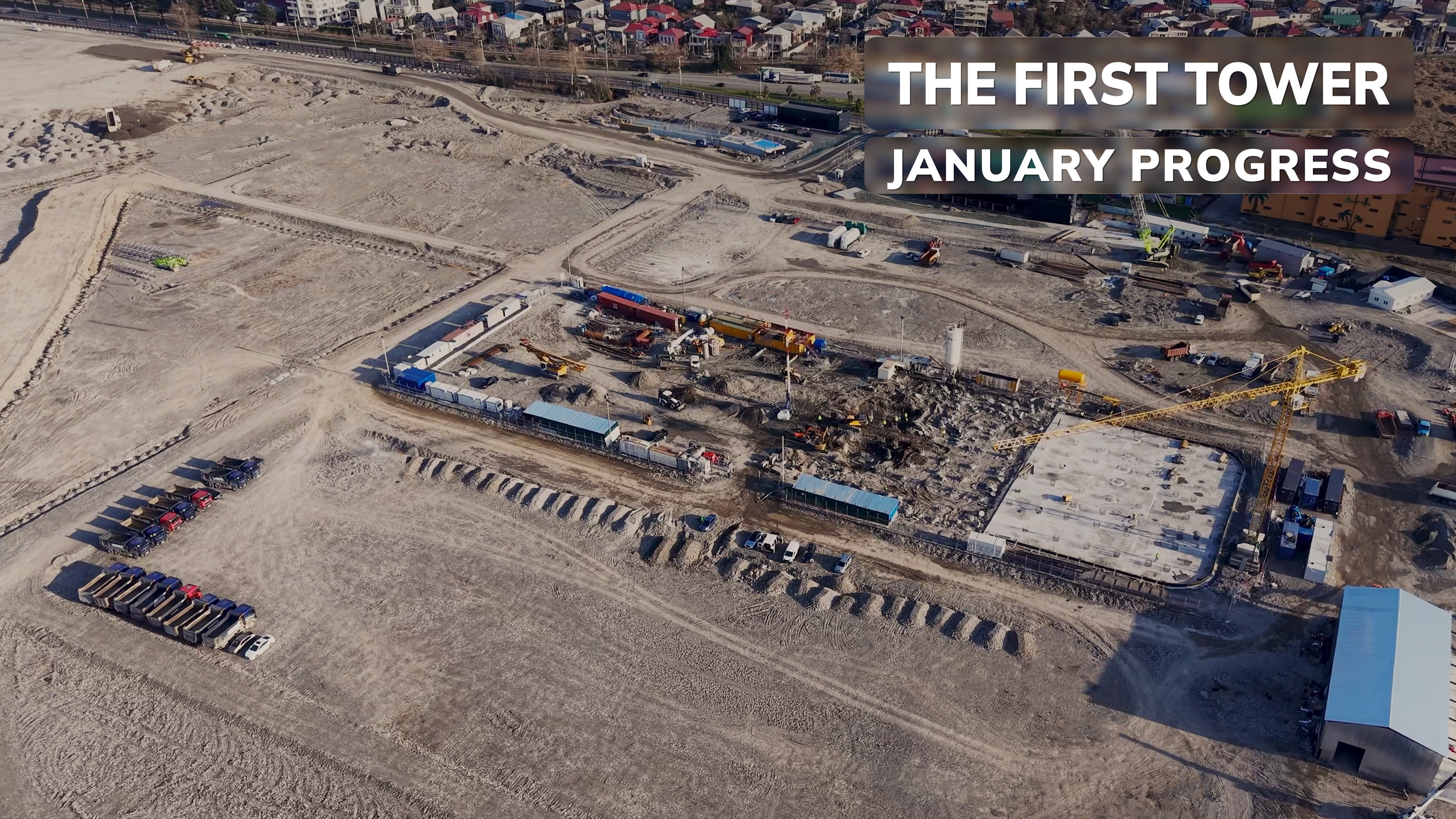

JANUARY, 2026
🖼️3 photos
20 JANUARY 2026

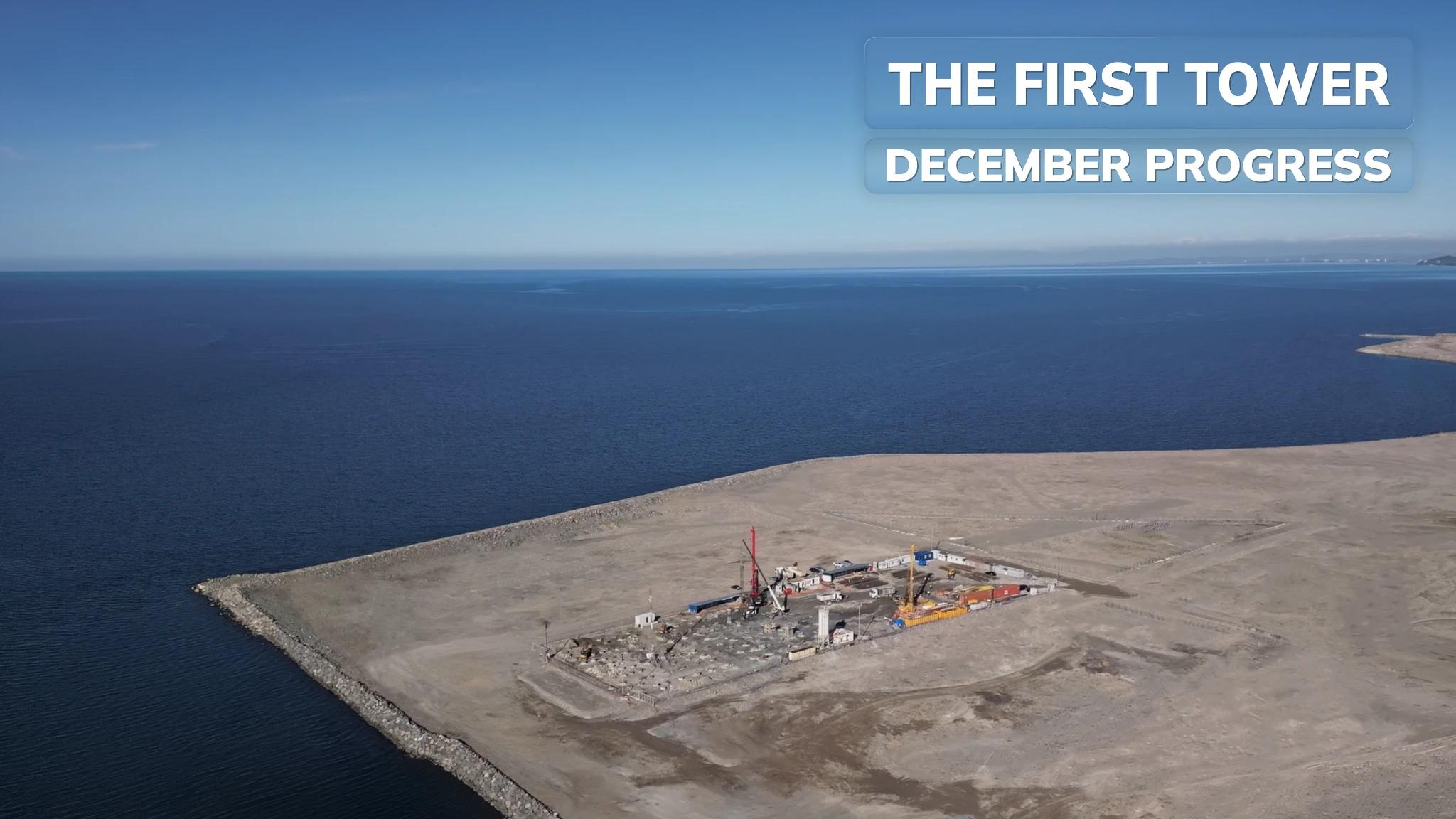

DECEMBER, 2025
🖼️3 photos
20 DECEMBER 2025
